Interstate 189

Interstate 189

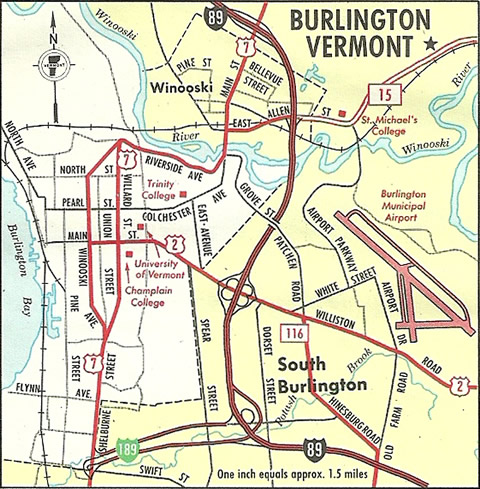

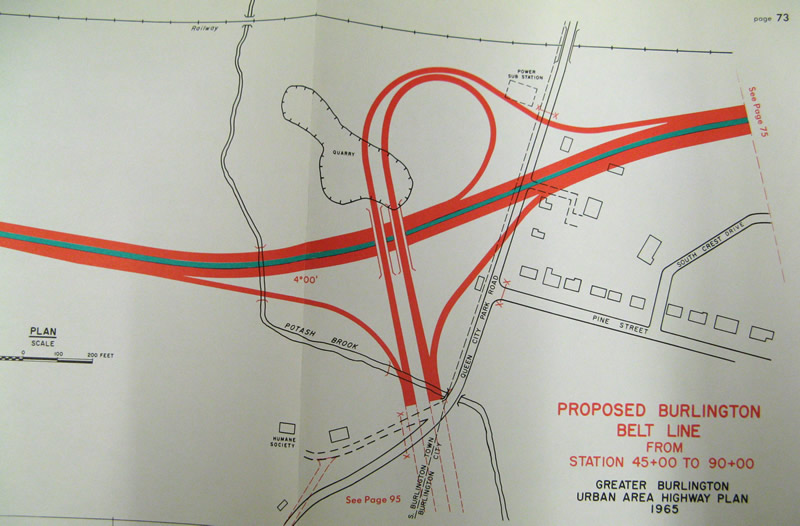

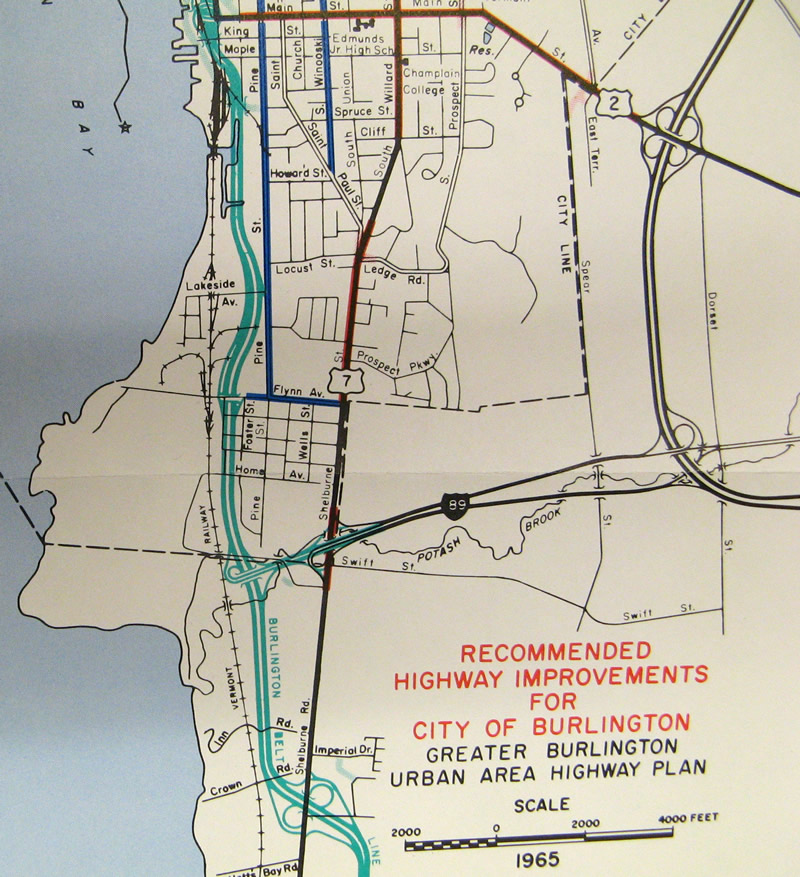

Opened in 1962, Interstate 189 provides a short freeway connection between U.S. 7 (Shelburne Road) and I-89 in South Burlington. The four lane freeway is posted at 55 miles per hour. Extensions of Interstate 189 west were planned to tie the route into the Burlington Belt Line in 1965 and Downtown Burlington via the Southern Connector in 1979.

The Southern Connector was proposed by the early 1970s to follow Pine Street north from I-189 to a curve linking with the southern end of Battery Street. The discovery of contaminated soil around the Pine Street Barge Canal halted work on the expressway north of Pine Street. Nonetheless, "C-1 Segment" of the Southern Connector was constructed in 1981 to the west of U.S. 7.

1980s plans focused on an alternate route for the Southern Connector, with Lakeside Avenue and Pine Street considered as corridors extending north to Downtown (Baird, 2015). The interchange between I-189 and U.S. 7 was originally configured as a trumpet, with a direct connection from westbound to southbound. That ramp was later closed and all westbound traffic redirected to a signalized intersection with U.S. 7.

Plans shifted in the 1990s on the renamed Champlain Parkway to turn north through more residential areas. The design was scaled back from a four lane to two lane roadway by the early 2000s. Main Street was the designated endpoint. Approval for the project was granted by District 4 Environmental Commission on April 27, 2012. Subsequent legal hurdles arose, halting momentum on the project to the issuing of a land-use permit by the Environmental Commission on August 25, 2014. Plans continued into 2015 with the route intended to connect Pine and Battery Streets through the eastern edge of the Vermont Railway yard (Baird, 2015).

Construction on Champlain Parkway finally got underway with the awarding of a $44.8 million contract on May 10, 2022 for the first phase of work. The initial contract built the segment of Champlain Parkway between Home Avenue and Lakeside Avenue while making upgrading Lakeside Avenue and rebuilding a portion of Pine Street. This work ran from Summer 2022 to December 2024 (The City of Burlington, 2026).

A $14.4 million contract was awarded for the second phase of construction on August 14, 2024. Construction got underway in January 2025 on the segment of Champlain Parkway from I-189 at U.S. 7 to Home Avenue. Reconstruction of Pine Avenue between Kilburn Street and Main Street is included in the work underway through Summer 2026 (The City of Burlington, 2026).

References:

Baird, J. (2015, February 19). Message in a bottleneck: Champlain Parkway. Burlington Free Press. https://www.burlingtonfreepress.com/story/news/local/2015/02/18/message-bottleneck-burlington-mayoral-candidates-debate-champlain-parkway/23577475/

The City of Burlington. (n.d.). Champlain Parkway Project Overview. Retrieved April 14, 2026 from https://www.champlainparkway.com/overview.
