Interstate 4

Interstate 4
Interstate 4 crosses the St. Johns River Veterans Memorial Bridges between Lake Monroe in Seminole County and Enterprise in Volusia County. 09/02/19, 06/29/08

Interstate 4 angles northeast across the Florida peninsula, traveling 132 miles from Tampa to Lakeland, Orlando and Daytona Beach. The intrastate route serves major population areas in Central Florida along the U.S. 92 corridor. Heavy development along the freeway over the years resulted in several toll roads to provide alternate routes and relief, including the Central Florida GreeneWay / Seminole Expressway (bypass to the east of Orlando), Daniel Webster Western Beltway / Wekiva Parkway (bypass to the west of Orlando), and Polk Parkway around Lakeland. Additionally much of the freeway was expanded to six or more lanes, with the final four lane stretch in Volusia County expanded by Summer 2015.

Interstate 4 Florida Guides

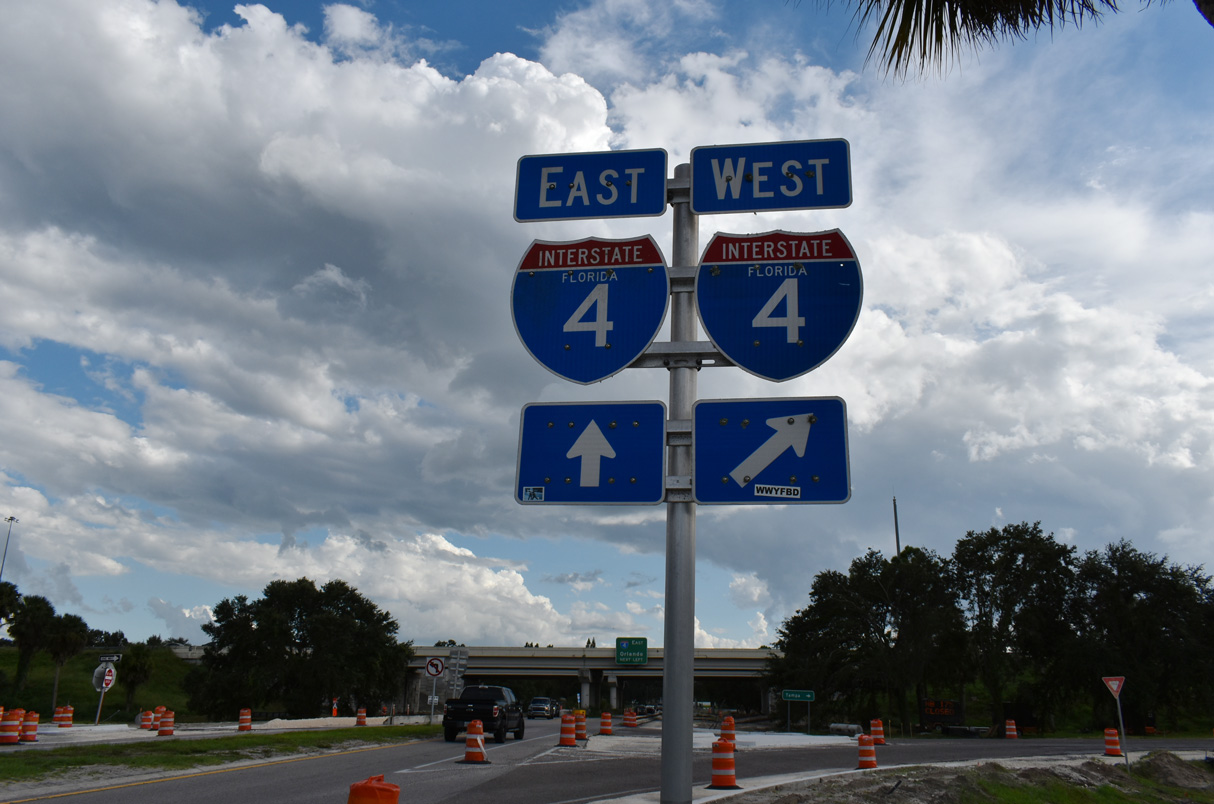

East

West

I-4 Ultimate Improvement Project

Commencing in 2015, $2.3 billion in road work expanded 21 miles of I-4 through Orange and Seminole Counties with two Express toll lanes in each direction. Ther I-4 Ultimate Project included the modification of 15 interchanges. The new toll lanes through the I-4 Ultimate Project area opened to traffic on February 26, 2022.

I-4 Beyond the Ultimate will further extend the I-4 Express Lanes in both directions for a total distance of 20 miles.

Interstate 4 through the Ultimate I-4 Project area between SR 408 (East-West Expressway) at Downtown Orlando and SR 423 (Lee Road) at Winter Park. 07/09/16

Separate work underway from June 2018 to 2022 added new flyovers directly linking Florida's Turnpike with Interstate 4. This construction was part of an $85 million project expanding the Turnpike to ten general use lanes from the Beachline Expressway (SR 528) north to I-4. Included was the installation of six new all electronic tolling points and the removal of toll booths along the ramp system connecting the Turnpike with I-4.

Construction of Interstate 4 occurred between 1958 and 1966. I-4 was dedicated in Tampa at a ribbon cutting ceremony held on October 5, 1964, when the last segment between Armenia Avenue and I-75, formally opened. The entire length doubles as hidden State Road 400, with SR 400 extending east from I-95 as an at-grade route to U.S. 1 in Daytona Beach.

Bids were opened by the Florida State Road Department on a 5.2 mile long section of State Road 400 leading east from U.S. 92 (Hillsborough Avenue) outside Tampa on November 26, 1957 ("Bids Asked", 1957). The next section of Interstate highway construction got underway on February 11, 1958. Costing $1,852,373, the 5.2 mile long section extended east from the junction of U.S. 92/301. The second phase of the link between U.S. 301 and Plant City went to bid for construction on February 18, 1958. This eight mile long segment tied into a previously built portion of limited access highway built on the north side of Plant City ("Work Starts Tuesday", 1958). The 4.75-mile long section at Plant City cost $2,467,083. It connected with with a $1,145,820, 2.8 mile long segment constructed east from the Hillsborough-Polk line toward Lakeland ("Work Starts On", 1957).

The first section of substantial Interstate highway construction in Florida was the 9.2 mile long segment of I-4 linking Plant City and Lakeland. $3.9 million in road work was completed in Fall 1958. $4.5 million in additional work extending the initial section west 13.7 miles toward Tampa (Blizin, 1959) was nearly finished by the weekend of November 13, 1959 (Delaney, 1959). Construction on a six mile long section of Interstate 4 in Polk County, one of the final contracts between Tampa and Orlando, got underway on December 1, 1959. The $1,634,254 contract built the four lane freeway from a point east of SR 33 northeast of Lakeland to a point east of what was the State Road 599 extension. Costing $1,600,714, work started on an additional section of I-4 on November 18, 1959 in Polk and Osceola Counties ("Polk Interstate Highway", 1959). The contract for the 4.8 mile long section had a completion date of October 1960 (Blizin, 1959).

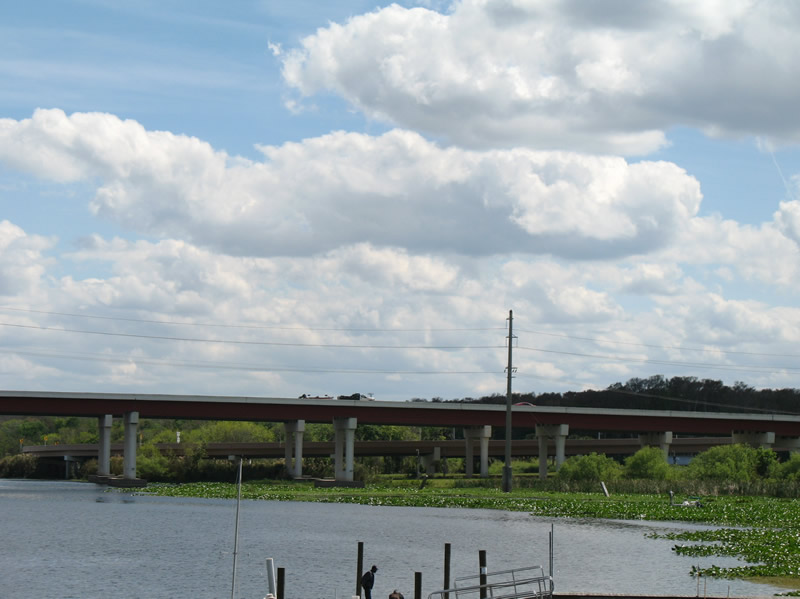

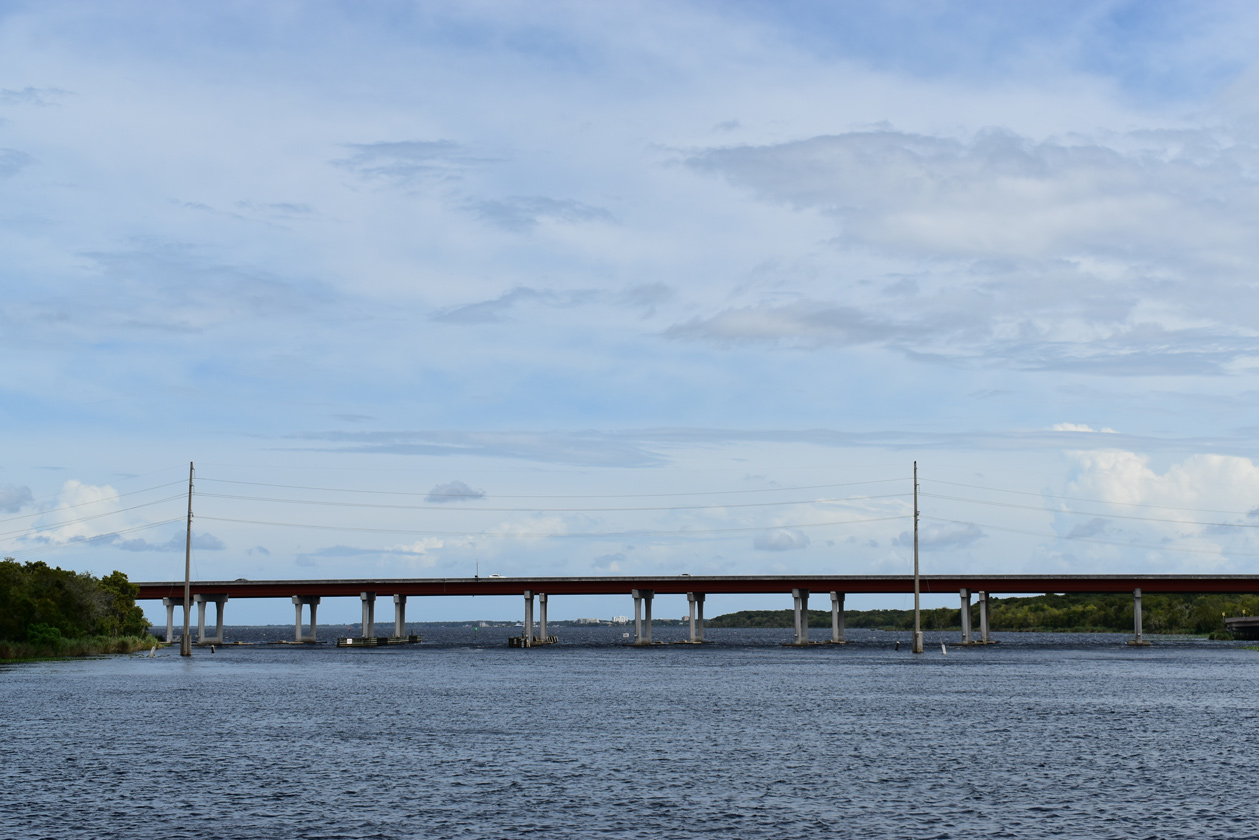

The St. Johns River Veterans Memorial Bridges at Lake Monroe were built during a $110 million project that included widening seven miles of I-4 north from CR 46A at Sanford to Saxon Boulevard in Deltona.2,3 Replacing a 56 foot wide, four-lane span built in 1960 for $1 million, work on the twin 58 foot wide bridges across the St. Johns River started on March 17, 2001.3,4 The westbound span opened initially for traffic exiting to U.S. 17/92 in January 2003,5 and with two lanes for the I-4 mainline on April 28, 2003.3 Following completion of the approaches, the eastbound span opened with two lanes on the morning of June 28, 2003. Nine months of demolition work for the old span commenced in July 2003.4 Construction at the St. Johns River wrapped up on May 25, 2004, when the third eastbound lane opened. Widening of I-4 westbound was finished in March 2003; work on eastbound to Saxon Boulevard continued through Summer 2003.2

References:

  1. Interstate 4 Direct Connect Ramps to Florida's Turnpike and Florida's Turnpike Improvements between the Beachline Expressway and Interstate 4 - Project fact sheet. http://floridasturnpike.com/content/ downloads/Current%20Project%20Descriptions/ I-4connector-pg1.jpg Florida's Turnpike web site.
  2. "Roll off the Barrels - I-4 Drives Will Get Some Relief as a Third Eastbound Lane Opens on Bridge." Orlando Sentinel, The (FL), May 22, 2004.
  3. "New I-4 span opens Monday - Westbound part of bridge ready." Daytona Beach News-Journal, The (FL), April 25, 2003.
  4. "Eastern I-4 traffic to see wider ride - Workers drive toward Saturday span opening." Daytona Beach News-Journal, The (FL), June 26, 2003.
  5. "It's Out with the Old -- in with the New - the Westbound Span of the New St. Johns River Bridge is Scheduled to Open Monday." Orlando Sentinel, The (FL), April 25, 2003.

References

Bids Asked On Interstate Road Link (1957, November 16) Tampa Morning Tribune, 11.

Work Starts Tuesday On Road Link With Lakeland (1958, February 7) Tampa Morning Tribune, 13-B.

Work Starts On Park of Road System (1957, June 30) Tampa Morning Tribune, 28-A.

Polk Interstate Highway Project to Start Soon. (1959, November 19). St. Petersburg Times, 5-B.

Blizin, J. (1959, November 17). Rural Areas Face Big Job In Superhighway Network. St. Petersburg Times, 9-D.

Delaney, R. (1959, November 11). Interstate 4 Link Ready. Orlando Sentinel, 1-B.
